Industrial Rainwater Management Design Guide
Industrial rainwater management captures runoff, diverts first flush, stores water, and treats it for a defined end use. Tank size must reflect rainfall, catchment area and material, daily demand, dry periods, flood-storage headroom, and water-quality risk. Roof area alone is not enough.
A good system has two measurable goals. It replaces purchased or abstracted water, and it attenuates peak runoff. Those goals can conflict. A full tank supports water supply but offers no capacity for the next storm. Therefore the design needs a drawdown rule, a safe overflow route, and a water balance built from local rainfall data.
End-Use and Treatment Decision Table
| End use | Main risks | Initial train to assess | Operating verification |
|---|---|---|---|
| Irrigation and area washdown | Sediment, colour, odour, operator exposure | Leaf screen, first-flush diversion, closed tank, simple settling/filtration | Visual turbidity, odour, deposits, nozzle condition |
| Toilet flushing and utility water | Aerosols, microbes, cross-connection | Screen + first flush + sediment filter + validated disinfection | Disinfectant indicator/residual, turbidity, backflow-prevention inspection |
| Cooling-tower make-up | TSS, microbes, changing mineral balance, corrosion | Filtration and disinfection; tower chemistry based on the blended make-up analysis | Conductivity, TSS, microbiology, corrosion coupons, cycles of concentration |
| Process, RO, or boiler feed | Seasonal variation, organics, microbes, tight process specification | Laboratory analysis followed by a specific train: filtration/UF, carbon, RO, or polishing as required | Parameters against process specification; feed and product trends |
| Potable water | Roof contamination, pathogens, materials/metals, health exposure | No direct use; multi-barrier treatment, validation, sampling, and drinking-water compliance are required | Tests against the applicable health standard and a surveillance programme |
| Flood retention/infiltration | Overflow, erosion, soil or groundwater contamination | Detention, controlled release, rain garden, or infiltration structure where ground conditions allow | Tank level, drawdown time, outlet condition, sediment, groundwater level |
This table is a starting point. It is not a substitute for risk assessment. Catchments near cooling-tower plumes, stacks, bird activity, dusty processes, or chemical handling need tighter controls. Some should be excluded from the harvesting system.

Understanding Rainwater Management

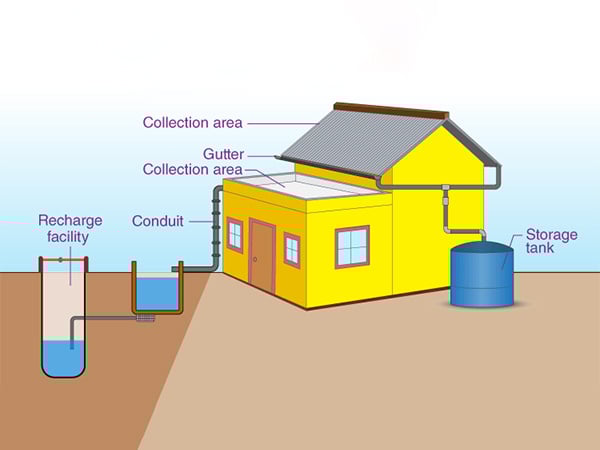

Rainwater management covers capture, conveyance, pretreatment, storage, treatment, distribution, overflow, and monitoring. Water reuse is only one outcome. On an industrial site, the system must also keep a safe flow path when storage is full. It must also prevent contaminated process-area runoff from entering the reuse tank.
As of July 2026, Indonesia’s Public Works Ministerial Regulation No. 11/PRT/M/2014 remains in force for rainwater management on buildings and their plots. It addresses rainwater use, infiltration, and temporary storage to preserve natural hydrology and reduce flood peaks. Please confirm site-specific mandatory-management status and technical requirements with the local authority and the facility’s building and environmental approvals.
Map every surface before design: clean roofs, loading bays, internal roads, parking areas, coal or chemical yards, and process areas. Do not combine comparatively controlled roof runoff with stormwater that may contain oil, solids, metals, or chemicals. This applies unless segregation and a suitable treatment route have been designed.
How to Estimate Harvestable Rainwater
For one rain event, the theoretical harvest is:
V (m³) = rainfall (mm) × catchment area (m²) × runoff coefficient ÷ 1,000
The runoff coefficient represents wetting, splash, leakage, and surface losses. Use a value from an accepted project design guide and calibrate it against metered performance. Do not copy one coefficient across every roof material.
Worked Yield Example
A 2,000 m² roof receives 50 mm of rain. The preliminary study assumes a runoff coefficient of 0.85. Therefore the volume reaching the harvesting system is:
50 × 2,000 × 0.85 ÷ 1,000 = 85 m³
The 85 m³ result is not automatically the tank size. Subtract first flush and treatment losses first. Then compare inflow with hourly/daily demand, initial tank level, the flood headroom you need, and the next likely storm. Annual design should use a locally representative daily or sub-daily rainfall series, such as the relevant BMKG station dataset, paired with the demand profile. Do not use annual-average rainfall alone.
Tank-Sizing and Water-Balance Worksheet
Build a time-step table with these fields:
| Input | Unit | Data source |
|---|---|---|
| Rain in each interval | mm | Representative rain gauge and agreed record period |
| Area of each catchment | m² | Roof/site survey and as-built drawings |
| Runoff coefficient | - | Accepted design guide and field calibration |
| First flush/loss | m³ | Water-quality strategy and commissioning results |
| Reuse demand | m³/interval | Water meter or process demand profile |
| Active tank capacity | m³ | Design alternative |
| Drawdown/controlled release | m³/interval | Flood objective and approved outlet condition |
For each interval calculate: closing storage = min(capacity, opening storage + inflow - first flush/loss - reuse - controlled release). Any excess is overflow. Test several tank sizes. Report at least supply reliability, annual reuse, overflow frequency, and flood-storage headroom before storms. The U.S. EPA’s current National Stormwater Calculator also shows why runoff, demand and cistern capacity should be assessed together. Use a locally appropriate model for the final design.

Rainwater Harvesting Process

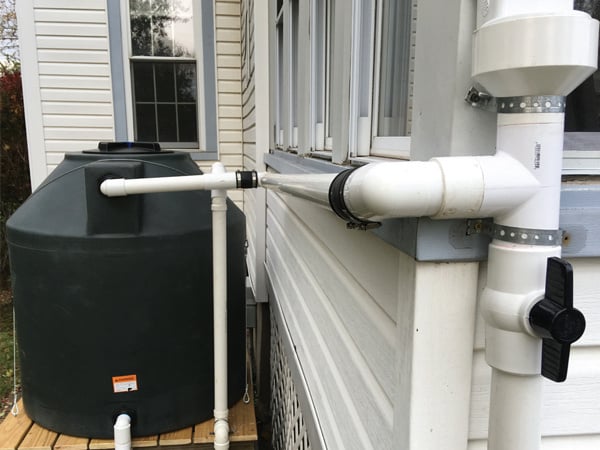

An operable train starts with an approved catchment, cleanable gutters and downpipes, a leaf/debris screen, first-flush diversion, calming inlet, closed tank, floating outlet or suction point above the sludge zone, treatment, and a dedicated distribution pipe. The overflow must be visible and erosion-resistant. It must connect to the approved drainage or infiltration route.
First flush is not a universal fixed volume. Set it from the catchment area and condition, the antecedent dry period, contaminant sources, early-storm sampling, and the end use. Discharge or treat first-flush water through an authorised route. Do not just move roof contaminants to the soil or a drain.
For industrial service, a steel media filter, cartridge filter, or ultrafiltration system may form part of the train when the solids profile and quality target support it. Use RO only when dissolved ions or the process specification need it. Low-mineral rainwater can still contain organics, microbes, and catchment-derived contaminants.

The Role of Technology in Rainwater Management
The most useful instruments trigger an operator action. A level transmitter shows available water and flood headroom. A rain gauge can support controlled pre-release. Turbidity or conductivity trends can flag changing quality. A flow meter proves actual reuse. A differential-pressure switch tells the team when a filter needs attention.
Use simple fail-safes: high-high level alarm, unobstructed overflow, low-level pump cut-out, backflow prevention, and an interlock that stops rainwater from entering the potable network. Online sensors do not replace laboratory sampling. Define the alarm limit, the response, who owns the action, and the post-calibration check.
If you select UV, control turbidity and UV transmittance first. Then monitor intensity and lamp hours as the equipment manual specifies. The sister-site guide to ultraviolet technology for water treatment explains how the equipment works. UV does not leave a disinfectant residual in the tank or the distribution system.

Environmental and Economic Benefits
Show the benefits with metering and a water balance. Record the cubic metres of rainwater that actually replace another supply, the treatment energy and chemicals per cubic metre, the retained overflow, the maintenance cost, and the downtime. Theoretical rainfall yield is not the same as delivered reuse.
The economic assessment includes tank, pumps, treatment, separate pipework, controls, space, inspections, media or lamp replacement, sampling, sludge disposal, and power. Compare those costs with the water genuinely displaced and the value of flood-risk reduction. For cooling or process use, include the effect of water quality on cycles of concentration, blowdown, corrosion, and production stability.

Challenges and Solutions in Rainwater Management
Quality changes between the beginning and end of a storm, between wet and dry seasons, and before and after roof maintenance. Tank space may be limited. However, oversized storage can create long residence times. Practical controls are catchment segregation, testable first-flush diversion, end-use treatment, controlled turnover, cleaning access, and a drawdown rule.
For potable use, never assume that “natural” rainwater is safe. Indonesia’s Minister of Health Regulation No. 2 of 2023 provides the current environmental-health and water-quality framework. Treatment, sampling points, test frequency, and accountability must match the end use and local requirements.
Monthly and Seasonal Inspection Checklist
- Clean approved roofs/catchments, gutters, screens, and downpipes. Record new contaminant sources.
- Test the first-flush valve, overflow, level alarm, low-level cut-out, and backflow prevention.
- Inspect the tank for light ingress, insects, leaks, odour, biofilm, and sediment accumulation.
- Record reuse flow, tank level, overflow, filter differential pressure, and disinfectant/energy use.
- Sample at the tank inlet and after treatment under the risk plan. Trend the results. Do not just file certificates.
- Clean or replace filters based on differential pressure and product quality. Do not go by the calendar alone.
- Before the wet season, clear the overflow, detention structure, and downstream drainage route.
- After roof work, a spill, fire, or long dry period, isolate the catchment until inspection and flushing are complete.
PT Beta Pramesti Asia can help define the water balance, treatment train, storage, controls and performance test for an industrial rainwater-reuse system. Send the catchment areas, rainfall series, demand profile, water analysis and end-use target through the Beta Pramesti Asia contact page. Then competing proposals share one design basis.
